Pricing you can read.

Most studios quote a number. We hand you a method, a framework, and a bill of quantities.

On this page: how we price, what’s in each package, a live calculator, a sample BOQ from a finished project, and the rules that govern the only times a number ever moves.

· This is the long version. If you'd rather talk first, the consult is free.

01 · METHODOLOGY

The CLARITY framework, gate by gate.

Seven gates between the first call and the handover. Each one ends with a deliverable you can hold, a sign-off you can read, and a number that's either confirmed or still bracketed. Nothing skips ahead. Nothing changes without a written variation. The framework is the contract between us — not the marketing.

GATE 01

CONSULT

A free, structured conversation. Your home, the brief, the constraints, the must-haves, the must-not-haves. We share past work and a rough budget bracket — not a quote. You leave with a written summary, not a pitch deck.

You walk away with

Brief summary (PDF)
Rough budget bracket
Project feasibility note

Duration

60–90 min

GATE 02

LAYOUT

Site survey, measurement drawing, and two layout options — drawn to scale, with circulation diagrams. We discuss trade-offs in plain language: what you gain, what you give up. One option is selected; we proceed.

You walk away with

Measured drawing
2 × layout options (A2)
Trade-off notes

Duration

5–7 days

GATE 03

AESTHETIC

Mood, materials, palette, finishes. Two visual directions, each with sampled materials, finish boards, and three reference projects. Selected direction becomes the spec language for everything downstream.

You walk away with

2 × mood directions
Material & finish board
Approved palette

Duration

5–7 days

GATE 04

RENDER

Photoreal 3D walkthroughs of every key room. We iterate twice as a baseline — more if needed. Renders are the final visual contract: what you see is what you’ll get, within real-world material variance.

You walk away with

Photoreal renders
2 revision rounds
Approved 3D


Duration

7–10 days

GATE 05

Item-by-item BOQ

The number. Every item priced. Every vendor named. Every quantity written down. No round figures, no “miscellaneous” line. You sign the BOQ, not a brochure. This is where most projects pretend a price exists. Ours is where it actually does.

You walk away with

Line-item BOQ (Excel)
Vendor list
Payment schedule

Duration

5 days

GATE 06

Technical drawings

The build set. Working drawings, electrical, plumbing, joinery details, ceiling RCPs, false ceiling sections, MEP. The set the contractor builds from — and the set you can hand to anyone else if life intervenes.

You walk away with

Build set (PDF + DWG)
Vendor handoff pack
Site supervision plan

Duration

10 days

GATE 07

YIELD

Delivery. Site supervision twice a week. Snag list at week-before-handover. Walkthrough. Defects rectified within 7 days. You get the keys, the warranties, a 12-month aftercare window, and one final check at month six.

You walk away with

Handover doc
Vendor warranties
12-month aftercare

Duration

8–16 weeks

02 · THE SERVICES

Seven services.Two tracks.

Quick services are flat fees — try the studio without committing. Full projects are architect-led, priced per sqft, billed against a signed BOQ. Every row below shows what's in, what's out, and what it usually costs.

▸ Behomly fees only. Material + labour are separate and shown line-by-line in the BOQ.

Track 1

Quick Services

Flat fee · 48–72 hr · Credits 100% toward a Full project​

MOST CHOSEN

N° 01 — Quote Audit

Send us another studio’s quote. We read it line by line and tell you what’s missing, inflated, or quietly assumed.

₹999

Flat · 48 hr

Includes 5

Excludes

Best for

Anyone holding another quote and wondering what's really in it.

REMOTE

N° 02 — Online Design

A full design package, delivered remotely — single room. Kitchen, bedroom, living, bath, kids, balcony, or study.

₹15,000

FLAT · SINGLE ROOM

7–10 working days

Includes 7

Excludes

Best for

Out-of-city clients, single-room redos, or testing the design layer alone.

TRY US

N° 03 — Clarity Call

60 minutes with the architect. Bring drawings, photos, the brief — leave with a written action plan.

₹999

60 MIN · VIDEO

100% credit to any Full project (30 days)

Includes 6

Excludes

Best for

A first conversation when you're not yet sure what you need.

Track 2

Full Projects

Per sqft · BOQ-billed · 7-gate CLARITY framework

Essentials

N° 04 — Modular Mix + PMC
Kitchen, wardrobes, key joinery, plus design and on-site management. The package most 2 & 3 BHK clients actually need — without paying for civil they don’t.

₹178 /sqft

₹109 design + ₹69 PMC

Includes 9

Excludes

Typical Behomly fee

2 BHK · 800 sqft

₹1,42,400

3 BHK · 1,100 sqft

₹1,95,800

Behomly fee only. Total project cost (material + labour) is separate, shown line-by-line in the BOQ.

MOST POPULAR

N° 05 — Custom Design + PMC

Possession-fresh apartments and villas. Every surface, every fixture specified — and managed through execution. Built off our 2,595-line specification BOQ.

₹269/sqft

₹169 design + ₹100 PMC

Includes 13

Excludes

Typical Behomly fee

2 BHK · 800 sqft

₹2,15,200

3 BHK · 1,100 sqft

₹2,95,900

Behomly fee only. Total project cost (material + labour) is separate, shown line-by-line in the BOQ.

REBUILD

N° 06 — Renovation + PMC

Lived-in homes. Demolition, civil, surprises behind walls, society coordination — priced honestly with a visible 5–8% contingency line you’ll see, not absorb.

₹338/sqft

₹229 design + ₹109 PMC

Includes 14

Excludes

Typical Behomly fee

2 BHK · 800 sqft

₹2,70,400

3 BHK · 1,100 sqft

₹3,71,800

Behomly fee only. Total project cost (material + labour) is separate, shown line-by-line in the BOQ.

Hands-off

N° 07 — Turnkey

Single point of contact, single payment schedule. We handle design, vendors, execution, finishes, handover. You walk in. Quoted to scope after a site visit.

Custom

Quoted to scope

Site visit required

Includes 12

Excludes

Best for

Second homes, NRIs, and clients who want zero day-to-day involvement.

All Quick services credit toward a Full project.

All charges exclusive of 18% GST.

03 · ESTIMATE

A live range, brokendown by category.

Sliders for area, configuration, scope, and finish grade. The card shows the typical low and high for projects with your inputs — and the share each major category usually takes. It isn't a quote. The exact number lives in the BOQ. But it'll tell you the bracket before you spend a minute on a call.

Project estimator

V.02 · SPRING 2026
Carpet Area 800 sqft
Configuration
Scope
Finish Grade
Likely Range
Based on similar completed projects · Final number from BOQ after design phase
Modular & joinery
Civil & finishes
Furniture & soft
Electrical & lighting
Design fee
Contingency / misc
Mid-point estimate

04 · SPECIMEN

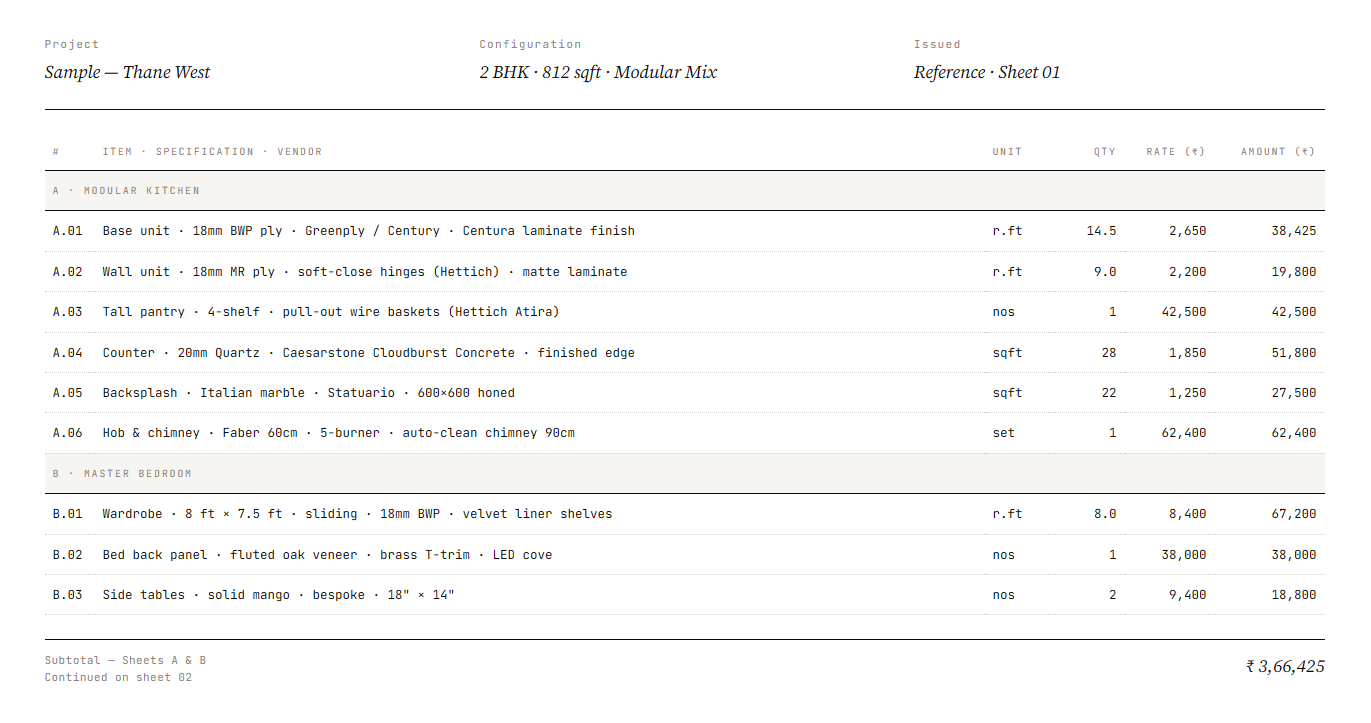

A real BOQ.Page one.

Below: the first page of the bill of quantities for a real 2 BHK Modular Mix project in Thane. Names redacted. Numbers as billed. This is what arrives at Gate 05 — and what you sign before any execution starts.

▸ A full BOQ runs 18–24 pages. You'll get yours as Excel

+ PDF.

Fairness

05 · Fairness

When budgets do move.

Real homes have moving parts. What we promise isn’t that nothing changes — it’s that nothing changes quietly, or in our favour, or without your written go-ahead.

These six rules govern every variation. They're written into your contract.

01

Every change gets a variation order.

Written. Numbered. Sent to you before any work proceeds. You sign, or it doesn't happen. No verbal changes — even ones we agree to on site.

02

You see the rate sheet, always.

The BOQ rates are the project rates — for the project's life. New items use those same rates. We don't quietly raise prices on things you can't easily compare.

03

Site discoveries get a contingency line.

Renovation BOQs carry a 5–8% contingency line — itemised, visible. If we don't use it, it doesn't get billed. Unspent contingency is yours.

04

Material price changes are pass-through, not markup.

If a vendor raises a rate mid-project, you see the original quote and the new one. Our margin doesn't grow because their price did.

05

You can change your mind. Once. Free.

Up to Gate 05 (BOQ sign-off), one major spec change per package — no charge. After that, variations are billed at cost + 10%, not at quote-stage premium rates.

06

If we underestimated, we eat it.

If something we missed at BOQ stage is genuinely our fault — drawing error, missed measurement, scope ambiguity — we cover it. Not you.

BEGIN

Sixty minutes.

No deck. No deposit.

One conversation. No obligation. You leave with a brief, a budget bracket, and a feasibility note — whether or not we end up working together.
